Mastering the Critical Path Method (CPM) in Project Management: A Comprehensive Guide with Primavera P6

Introduction: The Critical Path as a Game-Changer in Project Management

Every project, whether in construction, IT, infrastructure, or manufacturing, has a sequence of tasks that determines its overall duration. Delays in these tasks cause delays in the entire project. This is where the Critical Path Method (CPM) becomes invaluable.

This is where the Critical Path Method (CPM) becomes invaluable.

The Critical Path is the longest sequence of dependent activities that dictates the shortest possible completion time. It provides project managers and planners with crucial insights to optimize schedules, allocate resources efficiently, and mitigate risks before they become costly delays.

But how can we leverage CPM effectively?

With Primavera P6,project professionals can visualize, track, and manage the critical path dynamically, ensuring that projects remain on schedule and within budget.

This article provides a highly detailed, professional-level guide on:

✅ Understanding CPM concepts and calculations
✅ Implementing CPM in Primavera P6
✅ Case study of a real-world project
✅ The strategic value of CPM in project management

Let’s dive in.

1. Understanding the Critical Path Method (CPM)

Définition

The Critical Path represents the longest sequence of dependent tasks in a project. If any activity on the critical path is delayed, the entire project completion is delayed.
If any activity on the critical path is delayed, the entire project completion is delayed.

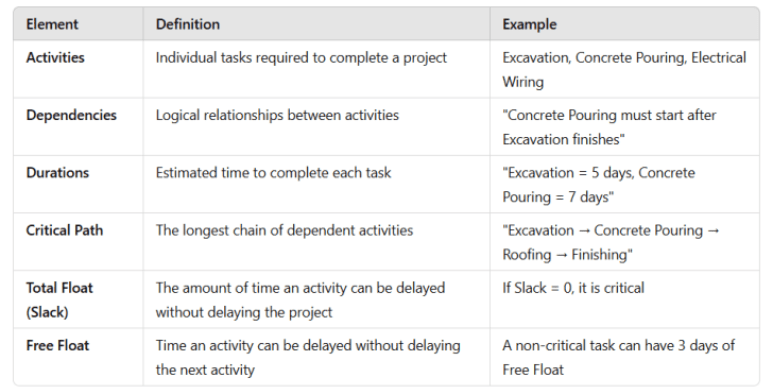

Core Elements of CPM

Formula to Identify the Critical Path:

Critical Path = Longest Path in the Project Schedule (Total Float = 0 days)
Project Duration = Sum of Activity Durations on the Critical Path



2. Implementing Critical Path in Primavera P6

Primavera P6, Primavera P6 is a powerful enterprise-level scheduling tool widely used for complex project planning.

Below is a step-by-step guide to defining the Critical Path in Primavera P6.



Step 1: Define the Work Breakdown Structure (WBS)

Break the project into structured work packages (foundation, structure, finishing, MEP, etc.).

Example: For a construction project, the WBS may include:

  • Site Preparation

  • Foundation Work

  • Structural Work

  • Finishing & MEP



Step 2: Define Activities

Under each WBS element, define specific activities.

Example: Under Foundation Work, we may have:

  • Excavation

  • Concrete Pouring

  • Curing & Formwork Removal



Step 3: Establish Activity Dependencies

Assign logical relationships

  • Finish-to-Start,

  • Start-to-Start,

  • Finish-to-Finish,

  • Start-to-Finish

Example:
Excavation → Concrete Pouring (Finish-to-Start relationship)



Step 4: Assign Durations & Schedule the Project

Example:

  • Excavation: 5 days

  • Concrete Pouring: 7 days

  • Curing: 10 days

In Primavera :
Go to "Project" → "Dates", define the start date, and click "Schedule" (F9).



Step 5: Identify the Critical Path

In Gantt Chart :
Go to "Gantt Chart" → Customize Layout → Select Total Float.

Activities with Total Float = 0 are on the Critical Path.



Step 6: Analyze & Optimize the Schedule

Use Primavera P6 tools to shorten the Critical Path:

✅ Fast-Tracking Fast-Tracking: Overlapping activities to reduce project duration.
✅ Allocating extra resources to shorten time. : allocation de ressources supplémentaires
✅ Logic Optimization: Adjusting dependencies to streamline execution.



3. Case Study: Applying Critical Path in a Real Construction Project

Project: High-Rise Office Construction

🔹 Duration: 180 days
🔹 Software Used: Primavera P6



Key Activities:

  • Site Preparation (10 Days)

  • Excavation (15 Days)

  • Foundation (20 Days)

  • Structural Framing (40 Days)

  • Roofing & External Cladding (25 Days)

  • MEP Installation (30 Days)

  • Interior Finishing (35 Days)

  • Final Inspection & Handover (5 Days)



Step 1: Define Dependencies

Site Preparation → Excavation (Finish-to-Start)
Excavation → Foundation (Finish-to-Start)
Foundation → Structural Work (Finish-to-Start)



Step 2: Run the Schedule in Primavera P6

Critical Path Identified:

🔴 Excavation → Foundation → Structural Work → Roofing → Finishing → Handover



Step 3: Project Delay & Recovery Plan

Problem: Excavation delayed by 5 days due to heavy rainfall.

✅ Solution: Applied Fast-Tracking by starting Foundation work in parallel with the final stages of excavation.

✅ Outcome: Saved 4 days of delay, reducing impact on final delivery.



4. The Strategic Value of CPM in Project Management

🔹 A. Improved Decision-Making

Real-time insights into project schedules allow managers to identify bottlenecks and adjust work sequences.



🔹 B. Better Resource Managemen

CPM ensures efficient allocation of manpower, materials, and equipment, reducing downtime and waste.



🔹 C. Risk Mitigation

Scenario analysis using CPM helps predict potential delays & risks before they escalate.



🔹 D. Enhanced Project Monitoring & Control

CPM integrates withEarned Value Management (EVM) to track schedule & cost performance indices (SPI & CPI).



🔹 E. Competitive Advantage

On-time project completion enhances company reputation, financial performance, and stakeholder trust.



Conclusion: Why Mastering CPM is Essential for Every Project Professional

The Critical Path Method (CPM) is a powerful project control tool that provides clarity, efficiency, and control over project execution.

When applied effectively in Primavera P6, it ensures:

✔ Accurate scheduling and forecasting
✔ Proactive delay management
✔ Optimized resource allocation
✔ Improved risk mitigation

Are you currently using Primavera P6 for scheduling?

What challenges have you faced in managing your Critical Path?



With Primavera P6, project professionals can visualize, track, and manage the critical path dynamically, ensuring that projects remain on schedule and within budget.
